What happens on an asbestos removal job, step by step

Eight photographs from our own work in Calgary, in the order the job actually runs — from the first sample to the weight ticket. This is what you are paying for.

Most people only ever see the quote and the invoice. Everything in between happens behind a sheet of poly with the door taped shut, which is exactly why the cheap quote and the right quote can look the same on paper. These are our own photographs from jobs in Calgary, in the order the work actually runs. Nothing staged, nothing borrowed.

1. Test first. Nothing is touched until the lab says what it is.

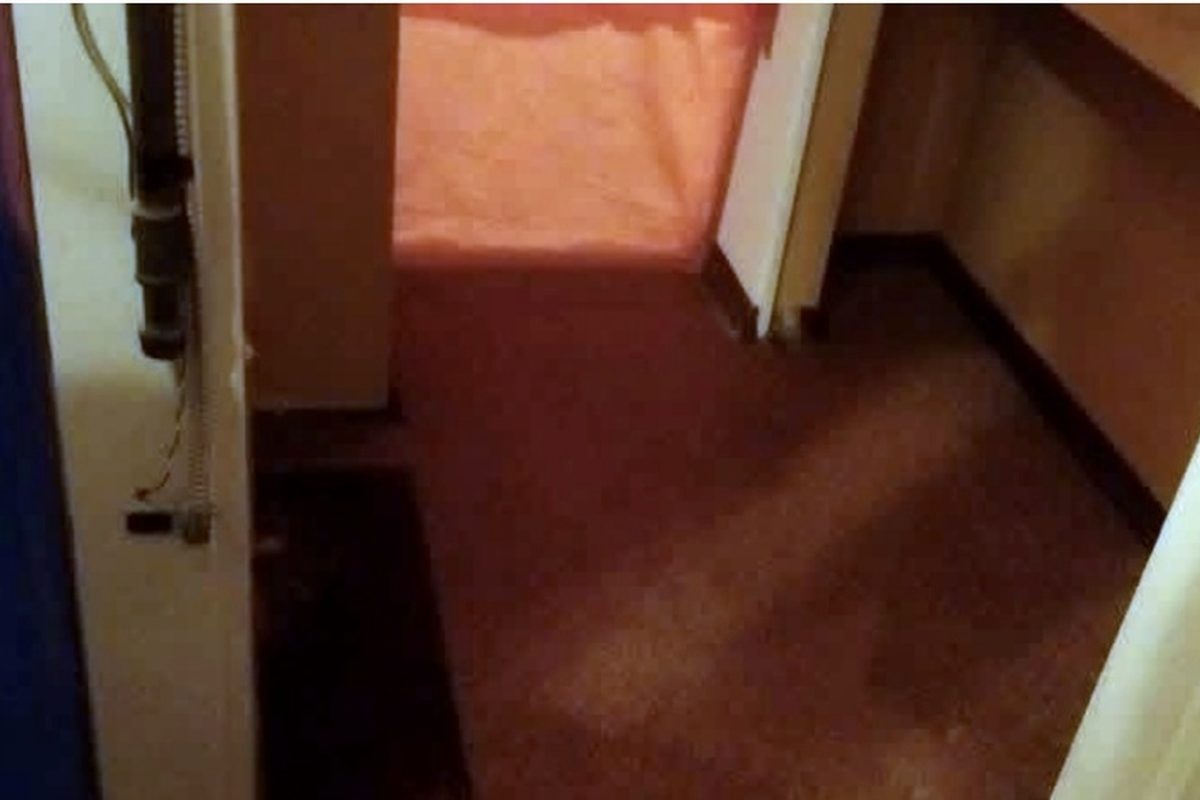

Corridor of a pre-1990 Calgary home with original carpet before asbestos testing
Before anything: original finishes in a pre-1990 home. Carpet, tile, ceiling texture and joint compound each get sampled separately.

A sampling visit comes first: three samples from different spots of each material, to an accredited laboratory, results in two to five days. What comes back decides the scope. Anything positive is removed under containment; anything clean is a normal renovation. Nobody swings a hammer until the report is in hand, because the moment a positive material is disturbed the whole house is in play.

2. Every opening gets sealed.

Doorway sealed with orange polyethylene sheeting and tape for asbestos containment
The line between the work area and the rest of the house: poly on every opening, taped floor to ceiling.

Doorways, windows, vents and returns are sealed with poly and tape. The work area becomes a room within a room. Anyone going in passes through a decontamination point, and nothing comes out unbagged. This step is the one that gets skipped when a quote is suspiciously low, and it is the one that decides whether the rest of your house is clean at the end.

3. Negative air runs the whole job.

Sealed room with windows covered in poly and a negative air machine duct running
A HEPA negative-air machine pulls air through the containment for the whole job, so fibres cannot drift into the rest of the home.

A HEPA-filtered negative-air machine draws air out of the containment continuously. Air moves in, through the filter, and out — never the other way. It runs from before the first piece comes down until after the clearance test, and it is the difference between a contained job and a house full of dust that looks clean.

4. Wet removal, bagged as we go.

Room stripped to subfloor with negative air machine running during asbestos removal
Material is kept damp, taken down in pieces and bagged inside the containment while the machine keeps running.

The material is kept wet so it cannot release fibres as it comes down. It is removed in pieces, not smashed, and goes straight into labelled bags inside the containment. Nothing is dry-scraped, swept or vacuumed with anything other than a HEPA vacuum. This is slower than the way it is sometimes done, and that is the point.

5. Where the job includes demolition, it happens inside the same containment.

Interior of a home stripped to the wall studs during a contained strip-out
Strip-out under containment: walls and ceilings come down with the same air control, so the renovation contractor starts in a clean shell.

A lot of our work is a strip-out as well as a removal. When the ceiling texture or the joint compound is positive, the drywall comes down under the same poly, with the same negative air, and the framing is left ready for the next trade. One contractor, one containment, one clearance at the end.

6. Waste: labelled, sealed, manifested.

Bin full of yellow labelled asbestos waste bags sealed for disposal
Double-bagged in labelled 6-mil bags, sealed, and taken to Shepard Landfill under permit. You get a copy of the paperwork.

Everything that comes out is double-bagged in labelled 6-mil bags, sealed, and delivered to Shepard Landfill by appointment under a City of Calgary Industrial Waste Permit. You receive the manifest and the weight ticket. That is your proof, for the sale, the permit, or the day someone asks. Where the waste goes, and why it matters.

7. What is underneath gets its own sample.

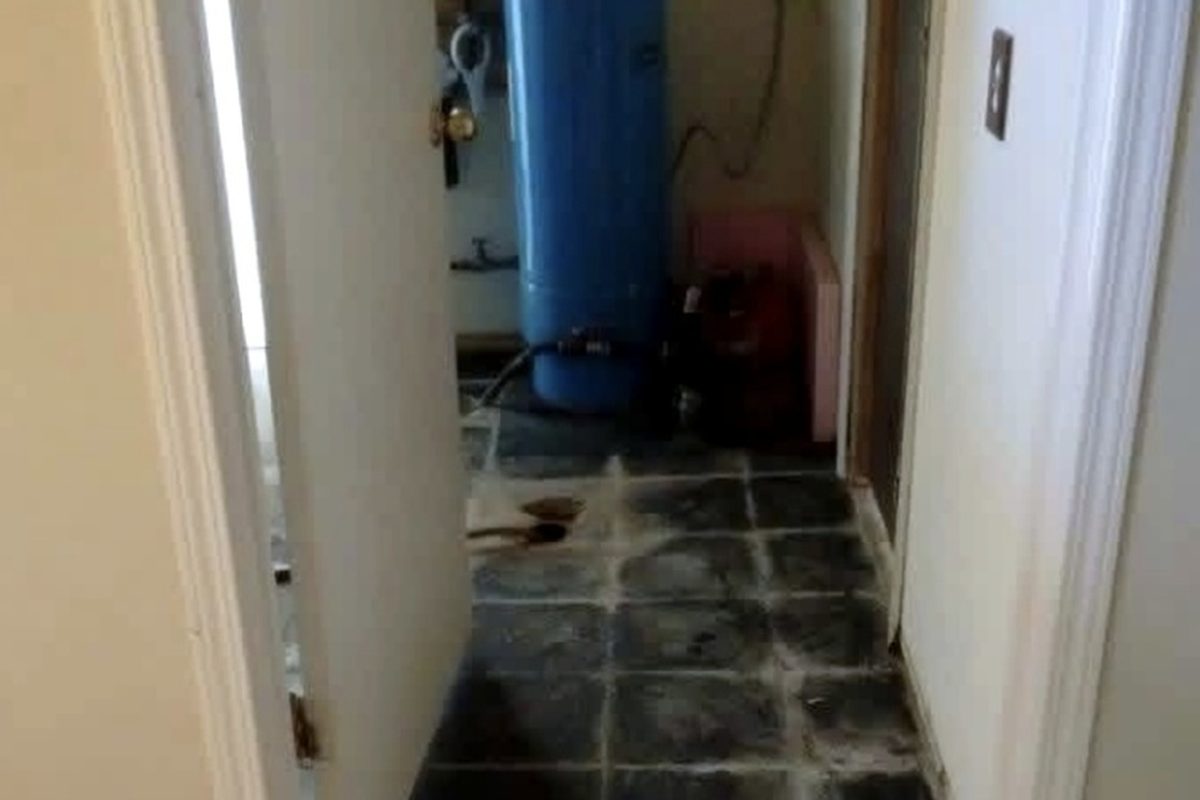

Hallway with carpet removed exposing old floor tile underneath
Carpet out, old tile underneath. What is under a finish gets tested before anyone lifts it.

Older homes are layers. Carpet over tile, tile over tile, texture over plaster. Each layer is a separate material and gets its own sample before it is disturbed. Old 9×9 tile and the black mastic under it are the classic surprise under a carpet, and finding out mid-job is how a one-day removal turns into a three-day one.

8. Cleaned, tested, cleared, handed over.

Cleared room stripped to framing with a fireplace and windows, ready for renovation
Clean, clear and documented. The next trade walks into a room that is safe to work in.

Every surface is HEPA-vacuumed and wet-wiped. An independent clearance test confirms the air is clean. Only then does the poly come down. You get the lab report, the clearance result, the manifest and the weight ticket, and your renovation contractor gets a shell that is safe to work in.

What to take from this

Ask any contractor quoting your job to walk you through these eight steps. Not in general terms — for your house. Which materials are being sampled, where the containment line will be, whether negative air runs for the whole job, where the waste is going and what paperwork you get back. A contractor who does the work this way can answer in a minute. One who cannot is the reason this page exists.

Prices for testing and removal are on the pricing page. To get started, book a sampling visit online or call (403) 477-2281.
